How Long Does It Take to Build a Backyard Basketball Court?

A typical backyard basketball court takes around 4 to 8 weeks from go-ahead to first game.
28 Sep
0
min read
The part most people picture, crews on site building the court, is usually done within a week or two. The rest of that time is council approvals (if your site needs one), concrete curing and weather, none of which you can see happening but all of which shape your real finish date.
We manage every phase of that timeline for you, so below is exactly what happens, in what order, and how long each step realistically takes.

Assessment, approvals and cure time can all happen without a single tradesperson on your property, which is why the calendar time is longer than the on-site time. Modular tile courts skip most of the cure wait, since tiles can go down as soon as the base is ready rather than after weeks of curing.

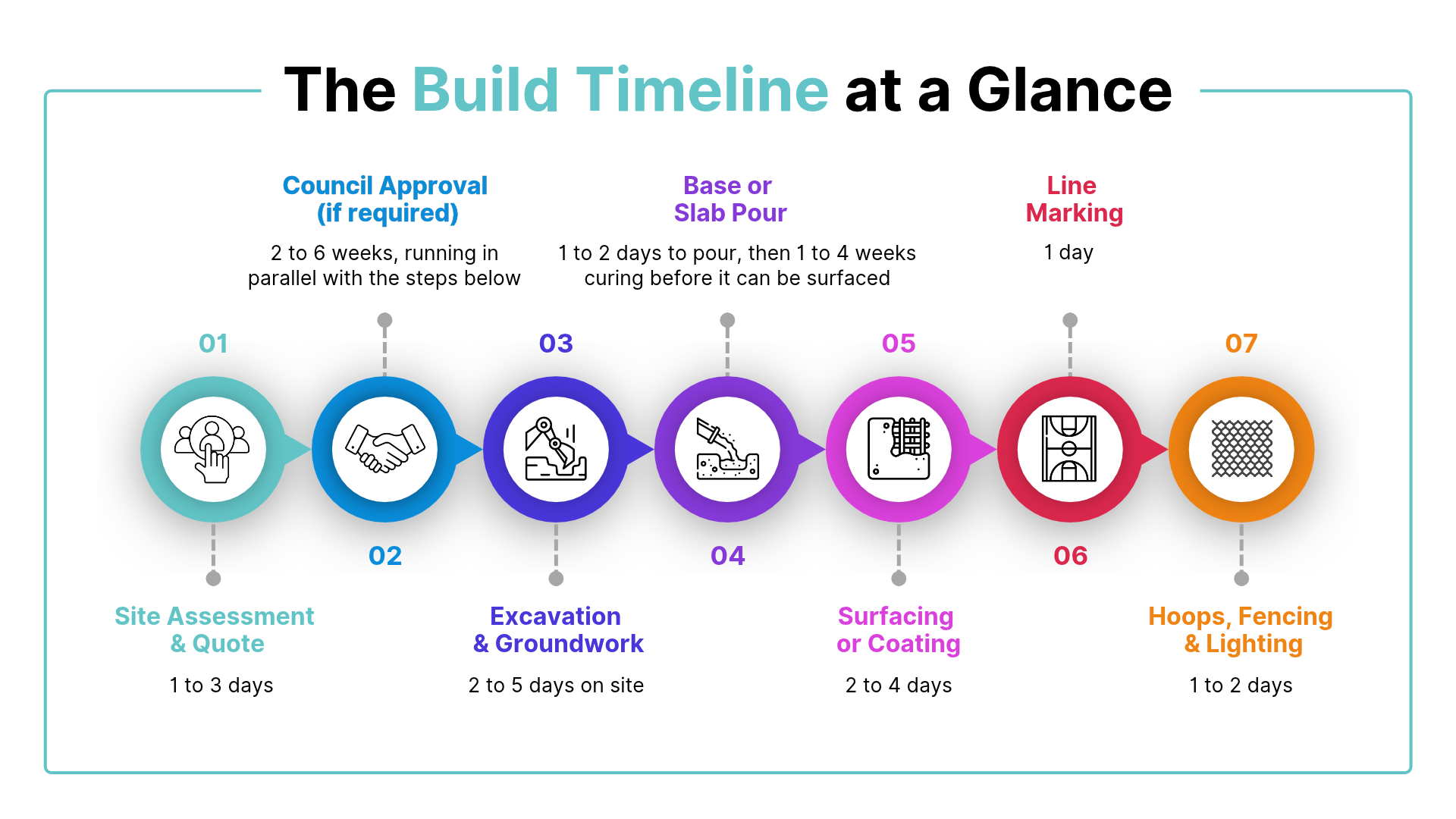

Each Stage of Building a Backyard Court (and How Long It Takes)
Whether you've already researched how to build a basketball court yourself or you're leaving it entirely to us, here's what each stage of the process actually involves and how long it realistically takes.
Site assessment & quote
We measure your space, talk through court size and surface options, and confirm your quote. This is usually a single site visit, with a firm quote following within a few days.
Council approval or permits
Not every backyard court needs approval, but courts with fencing, lighting, or a build close to a boundary often do. Our guide on whether you need council approval for a backyard court covers what typically triggers it. Where approval is required, this is the biggest wildcard in your timeline: some councils turn applications around in two weeks, others take six or more. We flag this early so it doesn't come as a surprise partway through.
Excavation & groundwork
Clearing the site, levelling, drainage and formwork happen here, and it's the phase most affected by your block itself. A flat, easily accessed backyard might take two days. A sloped block, tricky access for machinery, or soil that needs extra engineering can stretch this to four or five, and it's a major factor in your overall backyard basketball court installation timeline.
Laying the base
This is where most competitors gloss over the real timeline. A concrete slab needs to cure, properly, before it can be surfaced. Pouring takes a day or two, but a concrete basketball court base needs one to four weeks of cure time depending on thickness, weather and the engineering behind it, and rushing this step is how surfaces crack or delaminate later. If you're building on an existing hardstand, or choosing a modular tile system, you can skip most of this wait entirely.
Surfacing & coating
Acrylic coating is applied in layers and is weather-dependent. Rain or high humidity can push this out a day or two, since each coat needs to dry before the next goes on. Polymer tile installation is faster and less weather-sensitive, since it clicks into place rather than curing in the open air.
Line marking & colours
Once the surface is down, we mark out your court lines and any multisport markings, generally in a single day.
Hoops, fencing & lighting
The final stage covers your hoop system, any ball-containment fencing and lighting, and handover. Straightforward setups wrap up in a day; more elaborate accessory packages can take two.
If you want the fuller mechanics of each stage, see our step-by-step guide to how a basketball court is installed.
What Affects How Long Your Court Takes to Build?
Weather. Rain delays groundwork, slows concrete curing and can hold up acrylic coating, which needs dry conditions to go on properly.
Site access and slope. A block that's hard to get machinery into, or one that needs retaining work, adds days to groundwork that a flat, accessible site wouldn't need.
Council approval. Where it applies, this is the single biggest swing factor in your total timeline, since it can run for weeks before any physical work starts.
Court size and surface choice. A full court takes longer than a half court at every stage, and a poured slab with its cure time will always take longer overall than a modular tile system.
Extras. Fencing, lighting and custom accessories add their own day or two on top of the core build.
Does Building It Yourself Take Longer?
Usually, yes, and often by a lot more than people expect. A DIY build means sourcing materials yourself, working around a learning curve on techniques you've likely never done before, hiring or buying equipment, and working within your own available weekends rather than a scheduled crew. Get the cure timing wrong and you're looking at rework, which can turn a project you hoped to finish in a month into one that drags on for a season. If you're weighing it up, our guide to what a DIY basketball court actually involves is worth reading before you start.
A professional build trades that uncertainty for sequenced trades working to a schedule, correct cure timing built in from the start, weather management, and a warranty on the finished surface. It costs more than doing it yourself, but it's also the difference between a court in weeks and a project that might stretch across an entire summer.
How Long to Build a Basketball Court - FAQs
How long does a concrete basketball court take to cure before you can play?
A concrete base generally needs one to four weeks to cure properly before it can be surfaced, depending on thickness, reinforcement and weather. Surfacing before it's ready is one of the main causes of early cracking.
How long does a half court take vs a full court?
A half court is faster at almost every stage, from a smaller excavation and slab through to less surfacing and line marking. Expect a full court to add several extra days across groundwork and surfacing alone.
Can it be built in winter, or does rain delay it?
Yes, courts are built year-round in most of Australia, but rain can push out groundwork and delay acrylic coating, which needs dry conditions to cure properly between layers. Modular tile installs are less affected by weather.
How much does it cost to build?
Cost depends on court size, surface and your site's groundwork needs, and basketball court installation cost can vary significantly between a straightforward backyard and a sloped or hard-to-access one. See our full backyard basketball court cost guide for a detailed breakdown.
How long does a DIY backyard court take?
Considerably longer than a professional build in most cases, once you factor in sourcing materials, learning as you go, and working around your own weekends rather than a scheduled crew.
See How We Build It - Book a Consultation
Dream Courts manages every phase of your build, from the first site visit through approvals, groundwork and cure time, to the final line marking and handover, so you get a realistic schedule up front rather than a moving target. The exact timeline for your project comes from a site visit, since every backyard is different.
Request a consultation to get your build scheduled.
Planning your budget too? See what a backyard basketball court costs in our full price guide.
